Online
Health Monitoring System
Project Legacy
COP 4331, Fall, 2014
Modification history:
Version |
Date |
Who |
Comment |
v0.0 |
|
G. H. Walton |
Template |
v1.0 |
|
C. N. McCue |
First Revision |
|
|
|
|
Team Name: Team 14
Team Members:
Roles
Since team formation
and project selection took two weeks, it is considered Phase 0. Phase I consists of Deliverables I. Below is the work breakdown of Phase 1.
Deliverables
I Work Distribution |
Team
member(s) |
Work
Percentage |
Concepts of Operations |
Ethan, Chris M. |
50%, 50% |
Software Requirements Specification |
Jon, David |
50%, 50% |
Project Management Plan |
Chris M. |
100% |
Test Plan |
Chris C., James |
50%, 50% |
Video Chat Research |
James |
100% |
Quality Assurance, Revision and Compilation |
Chris M. |
100% |
Phase 2 is synonymous
with Deliverables II. Below is the work
breakdown of Phase II.
Deliverables II Work Distribution |
Team member(s) |
Work Percentage |
High-Level Design |
Chris M. |
100% |
Detailed:
Database Manager/Login/Settings |
James |
100% |
Detailed:
Alert Manager |
David |
100% |
Detailed:
Navigator |
Ethan |
100% |
Detailed:
Chat Manager |
Jon |
100% |
Detailed:
Pill/Appointment Manager |
Chris M. |
100% |
Detailed:
Calendar |
Chris C. |
100% |
Quality Assurance, Revision and Compilation
of DII |
Chris M. |
100% |
Presentation Slides |
All |
100% |
Presentation Outline, Revision and
Compilation |
Chris M. |
100% |
Although source code is
part of Deliverables III, we consider coding as a separate phase. Phase 4 consists of coding. Below is the work breakdown.
Code Work Distribution |
Team member(s) |
Work Percentage |
Research |
All |
100% |
Database Manager/Login/Settings |
James |
100% |
Alert Manager |
David |
100% |
Navigator |
Ethan |
100% |
Chat Manager |
Jon |
100% |
Pill/Appointment Manager |
Chris M. |
100% |
Calendar |
Chris C., Jon |
50%, 50% |
Database Integration Help |
James |
100% |
Code Integration |
All |
100% |
Unit Testing |
All |
100% |
Integration Testing |
All |
100% |
System Testing |
All |
100% |
Refactoring |
All |
100% |
Phase 3 consists of
Deliverables III. For source code, look
at the above table. Below is the work
breakdown for Deliverables III.
Deliverables III Work Distribution |
Team member(s) |
Work Percentage |
“User Manual” per each module |
All |
100% |
User Manual Revision and Compilation |
Ethan |
100% |
Build Instructions |
James |
100% |
Project Legacy |
Chris M. |
100% |
Test Results per each module |
All |
100% |
Test Results Revision and Compilation |
Chris C. |
100% |
Quality Assurance, Revision and Compilation
of DIII |
Chris M. |
100% |
Presentation Modules |
All |
100% |
Presentation Revision and Compilation |
Chris M. |
100% |
Below are all the routine
administrative tasks.
Routine Task Work Distribution |
Team member(s) |
Work Percentage |
Analysis, Bi-weekly Project Reports and Log
Tally |
Chris M. |
100% |
Meeting Agenda and Minutes |
Chris M. |
100% |
Website Administration |
Jon, Chris M. |
60%, 40% |
Individual Websites |
All |
100% |
Liaison |
Chris C., David |
100%, 100% |
Quality Assurance |
Chris M. |
100% |
Configuration Management |
All |
100% |
Analysis

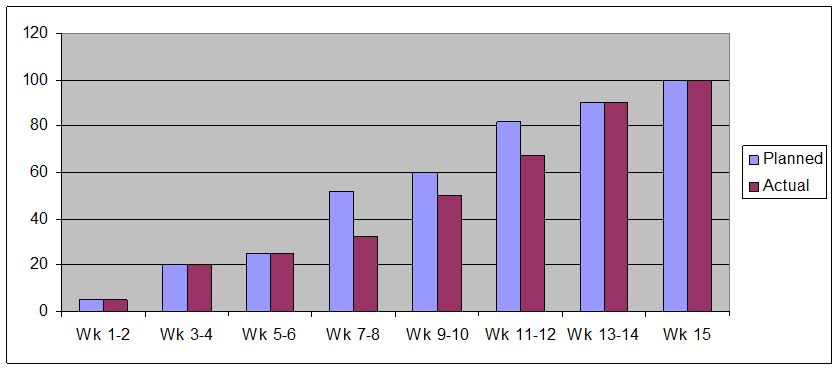

The chart below compares our overall progress
metrics from the bi-weekly reports with the expected overall metrics. As you can see, the progress was fairly
steady. Except for weeks 7-12, we were
on schedule throughout the project. Our
progress was behind for weeks 7-12 due to coding. During those weeks, our documentation was on
schedule.

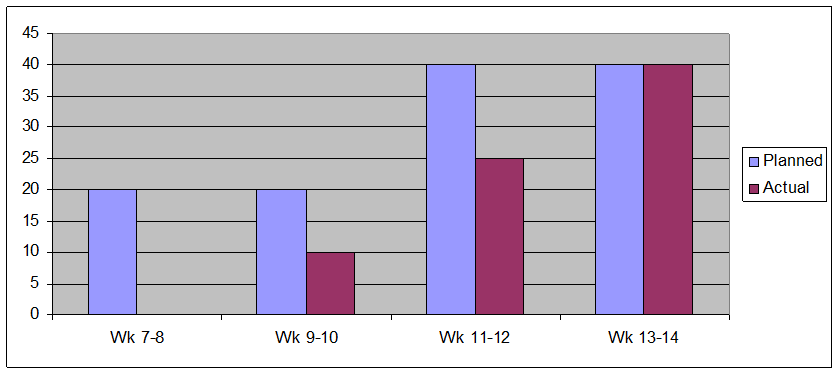

The chart below takes a closer look at coding
for weeks 7-14. This was the only major
issue we encountered. Though we were
behind, we rapidly caught up by week 14.

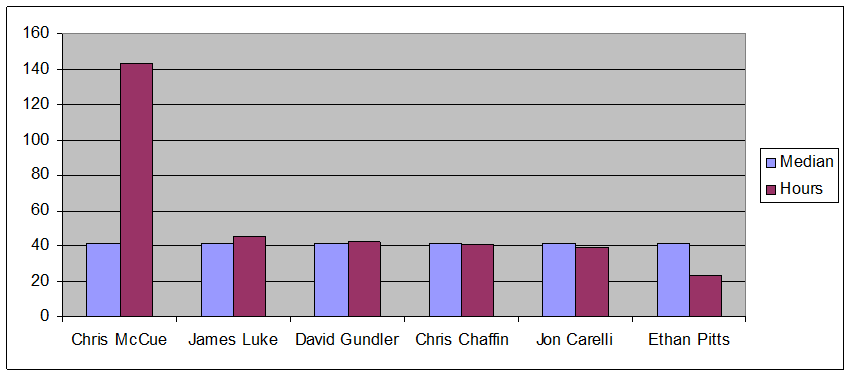

The chart below shows the hours worked per
team member. Most team members were
close to the median of 41.25 hours.
Chris McCue was extremely overworked, while Ethan was underworked.
The Online Health Monitoring System functions according to the “must have” requirements. The pill/appointment manager adds pill schedules and appointments for patients. It is robust. Pill schedule error checking consists of: no pill name entered, invalid dates, end time is less than start time and duplicate pill names. Appointment error checking consists of: invalid dates and duplicate appointments. The Calendar is updated with pill schedules and appointments. The Alert Manager sends pill schedules and appointment SMS alerts. The Chat Manager allows for doctor-patient and patient-doctor communication. The project works well. Everything is as expected. One can login to the website specified on the User’s Manual and use all the functionality.
The project meets the specified requirements. However, it would need modification for use in the real world. Currently, a patient can have one doctor, according to our requirements. More security would be required to make sure no one fakes being a doctor. These are examples of minor changes that would need to be implemented for real world use. The risk of lawsuits with medical applications is so great that we would hesitate to use this in the real world. However, in the university world, this is delivered as requested.
All work was finished to meet project requirements. There are only two minor known problems. The calendar of newly registered users shows the most recently logged in patient’s pill and appointment schedule until the new user gets adds a pill or appointment scheduled. Potential fixes include: New users automatically getting a dummy pill assigned to them once they register. Change algorithm to only display pills/appointments if a value is returned from database. If not, display nothing. Also, the SMS spam filter is sensitive. When the SMS code is turned off, that day’s information will be lost.
Overall, the team was able to
adhere to the project plan very well.
Administrative and technical tasks were divided equally among team
members. Communication was maintained
weekly with individual logs, emails and meetings before Deliverables. Corrective actions were taken as needed. For example, corrective actions were taken
with the Test Plan. During revisions of
deliverables, there was quality assurance to make sure standards were met on
documentation. Risks were minimized by
managing risks early on.
Overall, the team followed project
time estimates well. Weekly logs
included progress metrics. This made it
easy to assess weekly progress.
Occasionally, factors, such as homework in the Processes class or tests
in other classes, may have delayed items a day or two. However, a cushion was built into time
estimates to easily allow for this. Therefore,
we were able to accommodate these minor deviations. Much of the time was spent just keeping up
with the high priority items, such as next deliverable, presentation or meeting
deadline. Therefore, coding had to be
delayed a few weeks because of Deliverables II.
It was suppose to be in parallel with Deliverables II. This was our only major deviation.
Because of this, we were not
able to adhere to our planned software life cycle process well. We were not able to spend much time in
prototyping stage of incremental phased development. We had to go straight for integration. Our process more closely resembled agile
development.
The root cause of deviations from time estimates was the daunting task of documentation. The only major time deviation was coding. This was delayed because of the effort needed for Deliverables II. Since source code was not due until Deliverables III, it was lower priority. Besides this, there were only minor deviations of a day or two because of work load outside the project. Lower priority items did have a time lag. Outside of analysis of individual logs to assess progress and take corrective action at crucial points of the project, the Project Manager found the weekly analysis and bi-weekly project report to be a cumbersome, time-consuming activity of little worth. The Project Manager had a good sense of project time management without these reports and found them superfluous. Therefore, these low priority items often had to wait until all higher priority items were completed. This delayed reports for weeks. Configuration management also lagged. It took a while to post documents on the website after their completion. This was considered a lower priority item to be done when time permitted.
There were a total of 44
defects. One defect was introduced,
discovered and corrected during the code prototyping/unit testing phase. This was an email error. There were 38 defects that were introduced,
discovered and corrected during the code integration/integration testing
phase. Most of these errors occurred
because of Database or Navigator integration.
Until our code was integrated with the database, we could not really
test our modules. That is why so many
errors were discovered in the integration testing phase. There were 5 defects that were introduced
during the code integration stage, but discovered by other team members and
corrected during the system testing stage.
These errors consisted of David finding errors with the Pill/Appointment
Manager and Chris finding errors with the Calendar. In summary, most of our faults were caught
and corrected in the same phase of the project.
Also, most of our faults were due to integration. This was the most challenging stage of the
project.
In the end, quality assurance
was performed by the Project Manager during deliverable revision. This was sufficient to produce documentation
in line with team quality standards.
This was done in a timely manner before submission of deliverables. However, it was a burden for the Project
Manager. This could have been improved
if there were a person dedicated to quality assurance. However, this person would have to have a
good sense of documentation. This is a
rare quality to find among computer scientists and engineers.
The testing activities for our code were sufficient. Testing activities were performed in parallel with coding. Each module coder tested his code as he wrote it. Integration revolved around the Database Manager and Navigator. Integration testing was done by the module coder as we first integrated with the Database Manager and, then, with the Navigator. The tests were as timely as they could be, given that we were rushing to finish code before the demo. System testing occurred organically as we were putting the finishing touches on our modules. Given the time constraints of this project, our testing was optimal. If we had more time for this project, we would have each team member independent inspect the whole system for faults.
Every
team member was responsible for configuration management of his documentation
or code. The team website was used as a
hub for all documents. The author
retained a copy as well. Overall, these
were adequate for our small project in the short project life cycle. However, there was always a lag in the
posting of documents on the website since this was considered a lower
priority. There was only a minor problem
with configuration management of the SRS document when three of us were
modifying it at the same time. We were
able to revise the SRS properly. For a
larger project, our configuration management would need improvement. We could have improved configuration
management by using stricter guidelines, such as a document change form, and/or
having a dedicated person for configuration management.
For
source code, we uploaded our source code to the server during development. For final source code, we used Dropbox as a
repository. We never experienced any
configuration management problems with our code.
Given
the current team dynamics, the author feels that the technical processes put
into practice were optimal. Time
management and communications were handled well. However, these practices did cause overload
for the author. This would be an area
for improvement. No advice can offered
as to how this would be implemented as the author has not yet found a way to do
so.
For
future project teams, advice would be as follows:
Start
early with team formation and project selection.
Set
modest and realistic expectations for your project.
Set
deadlines with the expectation of procrastination being the norm. In other words, make early deadlines before
real deadlines.
Make
quality assurance and team expectations clear at the beginning.
Meet
and communicate frequently (at least weekly through individual log).
Follow-up
on progress through progress metrics in individual logs and remind frequently
of upcoming action items.
If
assigned a project 10 times the scope of this project, work distribution would
need to be more specific and guidelines would need to be more specific. Tasks, such as configuration management,
quality assurance and web maintenance, would need to be assigned to specific
individuals. There would need to be
meetings just to discuss guidelines and expectations, such as those in the
Project Management Plan. Much more time
would be needed to carefully articulate Deliverables I. The software life cycle process would be
followed more strictly. In summary, more
time would be needed before the design phase.
For a project 100 times the scope of this one, even the minutest tasks would require dedicated personnel. For example, there would be an individual dedicated to the project website. The team structure would need to be more hierarchical. There would be teams for design, teams for coding and teams for administrative tasks. A programmer may only have a vague idea of the big picture as tasks are subdivided again and again. For example, a programmer may work on a few classes of a module. The coder would never work on anything from Deliverables I. Deliverables III would become much more important as the code would need to be maintained. Code maintenance would be an important item to consider.
